Developing Construction Project Material Procurement Strategy using Integrated FMEA-DEA Approach in Kraljic’s Portfolio Matrix
Article Main Content
This research aims to develop procurement strategies for the Central Services Division at PT Freeport Indonesia, focusing on construction material procurement. The study integrates Failure Modes and Effects Analysis (FMEA), Data Envelopment Analysis (DEA), and the Kraljic’s Portfolio Matrix to address inefficiencies and improve material management practices. These methodologies help identify critical risk factors, assess supplier performance, and categorize materials based on their impact and supply risk. The study identifies that the procurement items are distributed across the Kraljic quadrants as follows: six items in the Leverage quadrant, ten items in the Strategic quadrant, nine items in the Bottleneck quadrant, and nine items in the Non-Critical quadrant. The findings provide a robust framework for enhancing procurement strategies, leading to cost savings, reduced material wastage, and improved operational efficiency.
Introduction
In the latter half of the 20th century, Indonesia’s mining industry underwent unprecedented expansion thanks to the discovery of vast mineral reserves. Among them was the Grasberg mine, operated by PT Freeport Indonesia (PTFI), which became renowned as one of the world’s largest deposits of gold and copper (PT. Freeport Indonesia, 2023). This landmark achievement attracted international investment and expertise, leading to the implementation of several underground mine expansion projects that were created to extend the life of the mine and access deeper ore reserves as open-pit mining reached its limits. Underground mining was anticipated to allow PT Freeport Indonesia to continue mining at the Grasberg mining complex until 2041.
To support and execute the underground mines expansion project, PTFI established the Central Services Division (CSD), which provides engineering, project management, construction, and commissioning (EPCC). The CSD also provides engineering and technical support to the company’s other divisions. The CSD faces challenging material management circumstances. This support is crucial for the integrated and efficient functioning of the company’s operations, especially in a complex mining environment.
Within years, some business issues related to material management arose from the current CSD operation. The dynamic of industry and PT Freeport Indonesia’s change affected those business issues, which can be dissected into two primary logistical challenges that impede operational efficiency:
Problem 1: Project Material not Available during Construction
This issue pertains to a critical supply chain inefficiency, manifesting as a deficiency in ensuring the suitable materials are available at the right time and place to meet construction schedules. This unavailability can be attributed to several factors, such as poor demand forecasting, lag in supplier lead times, or inefficiencies in inventory management. The repercussions of this unavailability are multifaceted, impacting the immediate timelines and cost structures of specific projects and the broader operational throughput.
Problem 2: Excessive Project Material Inventory at CONS Yard
Conversely, the second problem highlights an issue of inventory excess, wherein there is an accumulation of project materials beyond the current and projected needs. This can lead to wasted resources due to material perishability and reduced storage effectivity. This reflects a misalignment between inventory holding practices and the just-in-time (JIT) inventory philosophy, which advocates minimizing inventory levels and aligning them closely with the project schedules. Addressing this problem would involve strategies such as inventory optimization models, which balance the carrying costs against the ordering costs and service level requirements.
Both problems signify a disconnect between the anticipated project schedules and the realities of the material lifecycle within the CSD’s Material Management. The CSD needs to reevaluate its strategic procurement strategy.
Efficient procurement is critical for the success of large-scale construction projects. PT Freeport Indonesia (PTFI) has encountered significant challenges in managing surplus, stand-by materials, and material delivery delays, particularly in its Central Services Division. In recent years, the complexity of supply chains has increased, necessitating more sophisticated procurement strategies (Bardy & Hillebrand, 2011). Adopting a holistic, process-oriented approach to procurement that encompasses the entire value chain from sub-suppliers to end-users is important (Bardy & Hillebrand, 2011). This study addresses these challenges by integrating Failure Modes and Effects Analysis (FMEA), Data Envelopment Analysis (DEA), and the Kraljic Portfolio Matrix. These methodologies provide a comprehensive approach to identifying risks, evaluating supplier performance, and strategically categorizing materials, ultimately enhancing procurement and inventory management processes.
Literature Review
Integrating FMEA, DEA, and the Kraljic Portfolio Matrix provides a comprehensive approach to optimizing procurement strategies. FMEA allows for the identification and prioritization of risks in the procurement process. DEA evaluates the efficiency of suppliers and internal processes, highlighting areas for improvement. The Kraljic Portfolio Matrix then categorizes procurement items, guiding strategic decisions based on supply risk and profit impact. This integrated approach ensures that procurement strategies are robust, data-driven, and aligned with the overall cost reduction and operational efficiency goals.
Kraljic’s Portfolio Matrix
The Kraljic Portfolio Matrix, introduced by Peter Kraljic in 1983, is a strategic tool for classifying procurement items based on their supply risk and profit impact. Kraljic’s model divides items into four categories: non-critical, leverage, bottleneck, and strategic. Each category requires a different procurement strategy. For example, leverage items are typically high in profit impact but low in supply risk, suggesting that the organization can use its purchasing power to negotiate better terms. Bottleneck items have high supply risk and low-profit impact, requiring strategies to ensure supply continuity. This model helps companies to prioritize their procurement efforts and develop tailored strategies for different categories of items (Kraljic, 1983).
Failure Mode and Effects Analysis FMEA
FMEA is a highly effective and well-established method for identifying, categorizing, and analyzing failures to assess their associated risks. By implementing this method, we can identify failures and avoid their occurrence (Dagsuyuet al., 2016). Various industrial standards, such as those set by the Society of Automotive Engineers, the US Department of Defense, and the Automotive Industry Action Group, incorporate the Risk Priority Number (RPN) as a quantitative method to evaluate and prioritize potential failure modes. The RPN considers factors such as the likelihood of a failure occurring, the severity of the consequences if it does occur, and the ability to detect the failure before it causes harm.
This comprehensive approach allows organizations to proactively identify and address high-risk failure modes to enhance the safety and reliability of their products and processes. FMEA identifies potential failures by assigning a value or score for each failure mode based on occurrence level, severity level, and detection level (Stamatis, 2003). FMEA uses a score of 1 and 10 (with 1 being the best and 10 being the worst case) is given for each of the three factors and a risk-priority-number (RPN). Thus, the RPN value helps the FMEA team to identify the components or subsystems that need priority actions for improvement (Dinmohammadi & Shafiee, 2013).
Three main FMEA types have been formed since it was first developed, as follows (Carlson, 2012):
1. Design FMEA
2. Process FMEA
3. System FMEA
In certain studies, Failure Mode and Effects Analysis (FMEA) has been combined with Multiple-Criteria Decision-Making (MCDM) techniques to improve the process (Chanamool & Thanakorn, 2016). Different decision-making methods have been used to prioritize the risks identified in the FMEA. (Yousefiet al., 2018). One of these techniques is Data Envelopment Analysis (DEA) (Chinet al., 2009), which will be explained in the following section.
Data Envelopment Analysis (DEA)
Data Envelopment Analysis (DEA) is a linear programming methodology used to assess the efficiency of decision-making units (DMUs) such as schools, hospitals, or sales outlets (Charneset al., 1978). DEA evaluates relative efficiency in situations with one or multiple inputs and outputs. The model needs to be run individually for each unit to determine the relative efficiency of all DMUs. DEA categorizes DMUs into efficient and inefficient units. Initially proposed by Charneset al. (1978) (CCR model), other scholars further refined DEA. The DEA models traditionally rely on the linearity assumption for the virtual inputs and outputs (i.e., the weights coupled with the ratio scales of the inputs and outputs imply linear value functions) (Despotiset al., 2010). Data Envelopment Analysis is a technique that enhances FMEA’s assessment capabilities. It suggests that DEA can provide a more comprehensive ranking of failure modes by considering multiple criteria and offering corrective information on the severity, occurrence, and detection of failures (Chang & Sun, 2009).
Research Methodology
This study employs a mixed methods approach to integrate FMEA, DEA, and the Kraljic Portfolio Matrix for material management optimization. Data were collected through interviews with stakeholders, analysis of inventory records, and field observations. The FMEA process involved identifying potential failure modes, their effects, and causes within the procurement process, assigning severity, occurrence, and detection scores to calculate the Risk Priority Number (RPN).
The author requested decision-makers to complete a questionnaire to assess the specified risk criteria using the FMEA approach. This method involves decision-makers drawing on their experience with each supply risk to evaluate the Occurrence (O), Severity (S), and Detection (D) factors for every failure mode and commodity criterion. The FMEA measures the maximum and minimum scoring of S, O, and D of every failure mode, which are geometrically averaged to reflect the overall risks of the failure modes. DEA was used to evaluate the efficiency of procurement processes and purchase order commodities.
The evaluation of commodities according to Profit Impact is quantitative. Using the DEA model, commodities evaluated their efficiency score to help classify them into high- and low-profit impacts for the Kraljic Portfolio Matrix. Inputs include quantity purchased, and outputs include lead time, total purchased value, and cost per unit.
After the scoring and DEA model implementation are completed, the assessment of supply risk and profit impact is consolidated within the Kraljic Portfolio Matrix utilizing Orange software. Orange is a powerful open-source data mining and machine learning tool that offers a user-friendly visual programming interface for robust data analysis and visualization. Notably, Orange employs the Euclidean distances model to transform all scores, ensuring a comprehensive and accurate perspective for decision-making.
Result
The research methodology involved the utilization of Process FMEA (Failure Mode and Effects Analysis) to systematically identify potential failure modes, their corresponding effects, and the root causes of failures. Additionally, the study entailed documenting the existing process controls implemented within the procurement of construction materials in the Central Services Division. The sub-processes within the procurement workflow were carefully assessed to identify those with higher priority levels, upon which detailed investigations into failure, effects, causes, and controls were executed. All data were identified through discussion and observations in the Central Services Division. The complete Process FMEA information is available in Table I.
Process | Process step | Potential failure mode | Potential effects of failure | Potential causes of failure | Current process controls |
---|---|---|---|---|---|
Procurement of construction material | Create material take off | Incorrect material and quantity requirement | Project delays, purchasing delays, cost overruns, overstocking, surplus material | Poor planning, wrong design, miscommunication,errors in bill of material | Engineering Services Requisition (ESR) review through call center |
Request quotation, request for bids | Delays in RFQ and bid issuance | Purchasing delays, Project delays | Administrative and communication bottlenecks | Communication email, request for a bids call center | |
Vendor selection | Incorrect supplier chosen | Poor quality, material delivery delays | Inadequate supplier evaluation, limited supplier | Bidding process, result review email | |
Placing purchase order | Purchase order errors | Incorrect material, delivery delays, incorrect quantity, overstocking | Data entry errors | Material take off call center step-by-step review process | |
Delivery scheduling | Delays in material delivery | Construction project delays | Logistics issues, supplier issues, custom clearance issues | Regular follow-ups with the expediting team, monitoring through the SAP system | |
Receive and inspect materials | Incomplete or defective materials received | Rework or project delays | Poor supplier quantity/quality control | Inspection upon arrival, packaging check, and count | |
Inventory management | Inventory mismanagement | Missing damaged material | Poor inventory and material tracking, lack of real-time data, inadequate storage facilities | Inventory database system, SAP system |
Upon completing the identification of all pertinent information in the Process FMEA, a scoring process was carried out for Severity (S), Occurrence (O), and Detection (D) by six internal Central Services stakeholders. This group of stakeholders comprised the Construction Manager, Procurement Section Head, Engineering Manager Section Head, Field Engineering Section Head, Senior Material Control Staff, and Project Control Section Head. The failure modes identified in FMEA are summarized in Table II.
Failure mode | Coding |
---|---|
Incorrect material and quantity requirement | FM1 |
Delays in RFQ and bid issuance | FM2 |
Incorrect supplier chosen | FM3 |
Purchase order errors | FM4 |
Delays in material delivery | FM5 |
Incomplete or defective materials received | FM6 |
Inventory mismanagement | FM7 |
To obtain the final values of the risk priority number (RPN) for every commodity and its associated failure modes, the author calculates the RPN using the geometric mean of every scoring of Severity (S), Occurrence (O), and Detection (D) in the questionnaire on the respective failure mode and then multiplies it as shown in (1).
Every stakeholder is asked to score 1 to 10, with 1 being the best and 10 being the worst case for each of the three factors and a priority (RPN). An example of RPN’s calculation is available in Table III.
Commodity | Incorrect material and quantity requirement | |||
---|---|---|---|---|
S | O | D | RPN | |
Actuator | 6.45 | 2.49 | 2.18 | 35.09 |
Audible device | 4.48 | 1.82 | 2.04 | 16.61 |
Cable brackets | 7.54 | 1.70 | 2.85 | 36.56 |
Cable trays | 7.74 | 1.91 | 3.05 | 45.05 |
Cables | 7.94 | 3.91 | 2.94 | 91.46 |
The complete list of supply risk RPN results for every commodity in a respective failure mode is available in Table IV. The next step is to evaluate supply risk and profit impact using the DEA model. Every commodity is calculated using the DEA model to obtain its efficiency score. For supply risk, the DEA model uses virtual input as input and risk criteria, which is the aggregate RPN of the commodity, as output. Meanwhile, for profit impact evaluation, the DEA model uses the total quantity purchased of the commodity as input. The model’s output uses Lead Time, Total Purchase Value, and commodity cost per unit obtained from internal Central Services data, which is shown in Table VIII.
Commodity | FM1 | FM2 | FM3 | FM4 | FM5 | FM6 | FM7 |
---|---|---|---|---|---|---|---|
Actuator | 46.59 | 75.6 | 43.9 | 45.36 | 116.48 | 46.59 | 75.6 |
Audible device | 25.92 | 37.54 | 24.96 | 24.64 | 72.58 | 25.92 | 37.54 |
Cable brackets | 43.2 | 37.44 | 25.27 | 27.22 | 63.84 | 43.2 | 37.44 |
Cable trays | 52.48 | 69.44 | 33.26 | 30.24 | 90.71 | 52.48 | 69.44 |
Cables | 112.64 | 84.66 | 48.64 | 61.71 | 103.68 | 112.64 | 84.66 |
CCTV | 26.21 | 24.96 | 23.18 | 24.84 | 43.47 | 26.21 | 24.96 |
Circuit breakers | 89.22 | 103.36 | 59.16 | 69.12 | 136.4 | 89.22 | 103.36 |
Compressor | 55.49 | 66.96 | 57.02 | 52.9 | 95.68 | 55.49 | 66.96 |
Conveyor | 134.06 | 151.01 | 107.52 | 85.56 | 186.37 | 134.06 | 151.01 |
Doors | 62.72 | 61.15 | 73.42 | 58.88 | 102.08 | 62.72 | 61.15 |
Ducting | 182.78 | 207.36 | 239.62 | 105.79 | 286.72 | 182.78 | 207.36 |
Electrical fittings | 103.36 | 95.68 | 98.6 | 73.08 | 168.9 | 103.36 | 95.68 |
Electrical panels | 103.36 | 102.67 | 86.77 | 59.16 | 149.41 | 103.36 | 102.67 |
Electrical switch | 98.19 | 109.12 | 92.8 | 73.08 | 163.07 | 98.19 | 109.12 |
Flowmeter | 92.93 | 86.64 | 63.23 | 48.38 | 99.36 | 92.93 | 86.64 |
FSS | 206.64 | 155.65 | 125.12 | 81.6 | 203.11 | 206.64 | 155.65 |
Furniture | 51.84 | 32.83 | 32.64 | 27.1 | 68.82 | 51.84 | 32.83 |
Gatic ditch | 36.29 | 32.83 | 26.88 | 28.34 | 68.82 | 36.29 | 32.83 |
Geotextile | 63.23 | 51.84 | 40.8 | 34.5 | 95.04 | 63.23 | 51.84 |
Interface panel | 117.76 | 119 | 95.3 | 62.64 | 146.16 | 117.76 | 119 |
Lighting | 111.87 | 91 | 47.42 | 47.04 | 116.93 | 111.87 | 91 |
Lube pump | 119.23 | 106.4 | 113.09 | 74.4 | 160.08 | 119.23 | 106.4 |
Paints | 33 | 23.12 | 16.46 | 20.16 | 49.39 | 33 | 23.12 |
Pipe fittings | 109.3 | 62.4 | 61.2 | 47.04 | 123.42 | 109.3 | 62.4 |
Pipes | 67.32 | 39.6 | 37.63 | 27.1 | 81.66 | 67.32 | 39.6 |
PLC panel | 146.83 | 153.92 | 167.44 | 98.95 | 198.4 | 146.83 | 153.92 |
Remote | 125.12 | 131.04 | 109.3 | 83.75 | 182.53 | 125.12 | 131.04 |
Steel | 134.06 | 127.3 | 87.7 | 70.99 | 163.33 | 134.06 | 127.3 |
Switch | 87.36 | 87.58 | 92.16 | 57.34 | 110.43 | 87.36 | 87.58 |
Terminations kits | 118.56 | 98.21 | 83.6 | 63.84 | 154.01 | 118.56 | 98.21 |
Transformer | 133.76 | 137.1 | 117.04 | 66.96 | 168.91 | 133.76 | 137.1 |
UPS | 67.2 | 62.93 | 71.28 | 46.37 | 122.73 | 67.2 | 62.93 |
Valves | 161.28 | 140 | 105.79 | 69.6 | 183.74 | 161.28 | 140 |
Wall material | 27.04 | 23.04 | 21.74 | 24.19 | 61.82 | 27.04 | 23.04 |
The complete list of evaluated supply risks and their impact on profits, as determined by the DEA model, is detailed in Table V.
Commodity | Supply risk | Profit impact |
---|---|---|
Actuator | 0.48045 | 0.81636 |
Audible device | 0.27927 | 0.90793 |
Cable brackets | 0.39764 | 0.58215 |
Cable trays | 0.43651 | 1 |
Cables | 0.69479 | 1 |
CCTV | 0.20717 | 0.40613 |
Circuit breakers | 0.75909 | 0.77129 |
Compressor | 0.42512 | 1 |
Conveyor | 0.80012 | 0.49000 |
Doors | 0.46952 | 0.47250 |
Ducting | 1 | 0.79059 |
Electrical fittings | 0.84010 | 0.58127 |
Electrical panels | 0.80665 | 1 |
Electrical switch | 0.80665 | 0.90884 |
Flowmeter | 0.59435 | 0.46744 |
FSS | 1 | 0.73360 |
Furniture | 0.26980 | 0.30645 |
Gatic ditch | 0.27812 | 0.19162 |
Geotextile | 0.35280 | 0.40303 |
Interface panel | 0.71871 | 0.58068 |
Lighting | 0.53412 | 1 |
Lube pump | 0.71716 | 0.72261 |
Paints | 0.20014 | 0.34519 |
Pipe fittings | 0.61495 | 1 |
Pipes | 0.41402 | 0.57221 |
PLC panel | 0.97463 | 1 |
Remote | 0.67950 | 1 |
Steel | 0.86593 | 0.40128 |
Switch | 0.73235 | 0.65047 |
Terminations kits | 0.79874 | 0.65300 |
Transformer | 0.70404 | 0.67584 |
UPS | 0.53452 | 0.85305 |
Valves | 0.85122 | 0.74583 |
Wall material | 0.29615 | 0.38339 |
The Orange software is used to analyze the efficiency scores for each commodity, and it will generate a Euclidean matrix. This Euclidean matrix, which represents the distances between different commodities regarding their efficiency scores, will then be fed into the Kraljic Portfolio Matrix. Kraljic’s Portfolio Matrix is a strategic tool used in procurement and supply chain management to classify products based on their importance and supply risk. This step is a crucial part of the analysis process. It helps in making informed decisions about procurement strategies, as shown in Fig. 1. The summary of classification obtained from plotting commodity supply risk and profit impact in the Kraljic Portfolio Matrix is shown in Table VI.

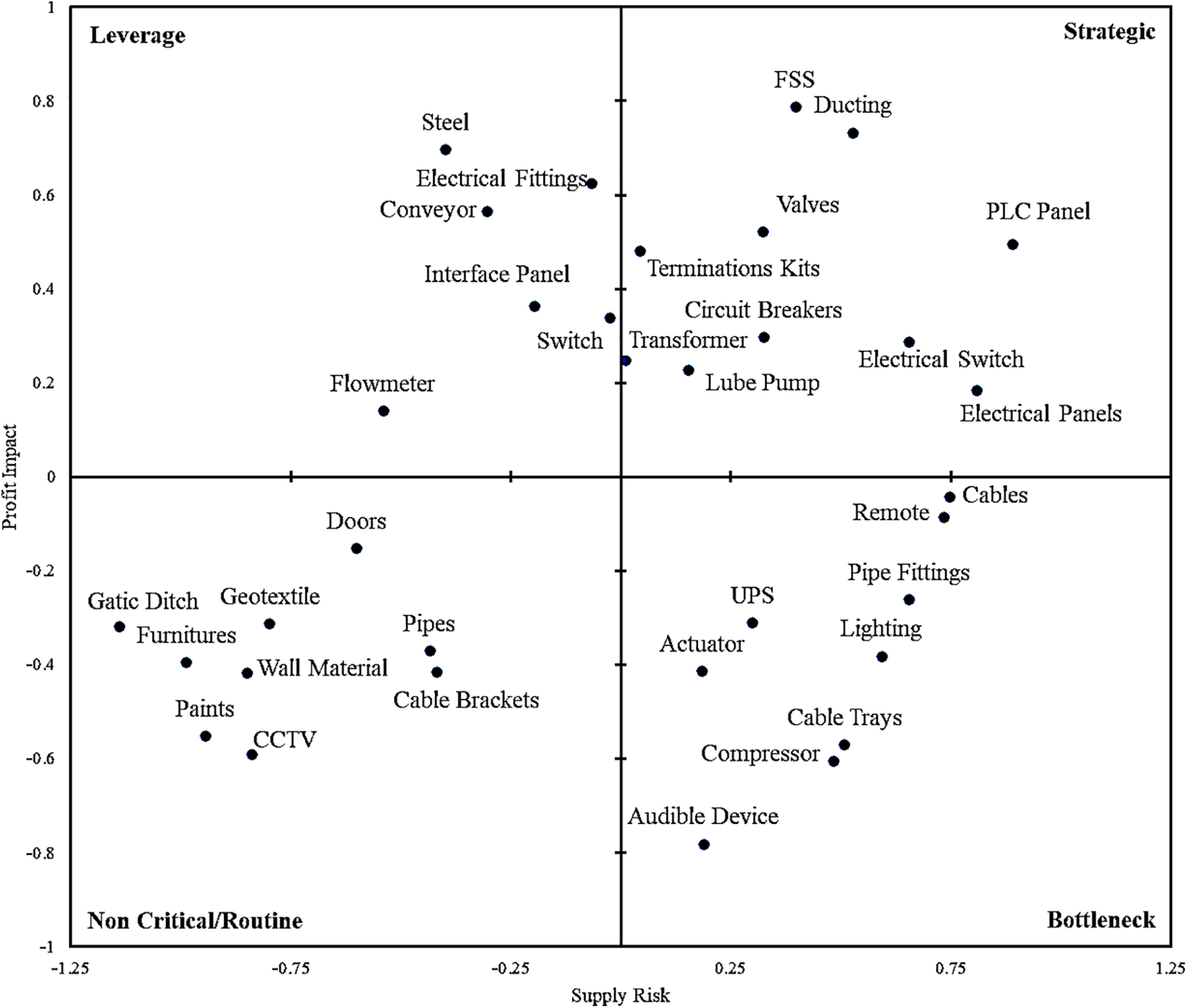

Fig. 1. Kraljic portfolio matrix for construction material procurement using euclidean distance model.
Commodity | Class | Commodity | Class |
---|---|---|---|
Actuator | Bottleneck | Gatic ditch | Non-Critical |
Audible device | Bottleneck | Geotextile | Non-Critical |
Cable brackets | Non-Critical | Interface panel | Leverage |
Cable trays | Bottleneck | Lighting | Bottleneck |
Cables | Bottleneck | Lube pump | Strategic |
CCTV | Non-Critical | Paints | Non-Critical |
Circuit breakers | Strategic | Pipe fittings | Bottleneck |
Compressor | Bottleneck | Pipes | Non-Critical |
Conveyor | Leverage | PLC panel | Strategic |
Doors | Non-Critical | Remote | Bottleneck |
Ducting | Strategic | Steel | Leverage |
Electrical fittings | Leverage | Switch | Leverage |
Electrical panels | Strategic | Terminations kits | Strategic |
Electrical switch | Strategic | Transformer | Strategic |
Flowmeter | Leverage | UPS | Bottleneck |
FSS | Strategic | Valves | Strategic |
Furniture | Non-Critical | Wall material | Non-Critical |
The non-critical quadrant comprises nine commodities with low-profit impact and low supply risk. While necessary, these commodities do not significantly affect the company’s profitability or supply stability. The Leverage quadrant contains six commodities with high-profit impact and low supply risk. These commodities contribute significantly to profitability and are sourced from stable markets. The Bottleneck quadrant is also one of the large quadrants, with nine commodities, indicating that many procurement commodities have a low-profit impact but high supply risk. If not managed properly, these items can disrupt operations. The strategic quadrant, which contains 10 commodities and is the largest among all quadrants, encompasses those with both high-profit impact and high supply risk. These commodities are critical to the company’s operations and profitability, necessitating a robust strategic approach.
Recommendation and Discussion
The Kraljic Portfolio Matrix is a critical tool for developing tailored procurement strategies by categorizing materials based on supply risk and profit impact. This framework aids organizations like PT Freeport Indonesia optimize their procurement process to enhance efficiency, minimize risks, and achieve cost savings. Below is a detailed narrative elaboration of the recommended procurement strategies for each matrix quadrant.
Leverage Items (High-Profit Impact, Low Supply Risk)
Materials in this category include steel, electrical fittings, conveyors, interface panels, switches, and flowmeters. These items are characterized by their significant impact on profits and relatively low supply risk. The primary strategy for leveraging items is maximizing purchasing power and negotiating favorable terms to reduce costs.
Recommended Strategies: To capitalize on the high-profit impact and low supply risk, competitive bidding should be employed to drive down prices. This involves inviting multiple suppliers to bid for contracts, fostering competition, and securing the best possible deals (Gaddeet al., 2010). Additionally, volume consolidation can be used to negotiate bulk discounts. By consolidating purchase orders, PT Freeport Indonesia can leverage higher volumes for better pricing and terms (Monczkaet al., 2015). Long-term contracts with suppliers can ensure price stability and supply security, further enhancing procurement efficiency. Continuous market analysis is crucial for monitoring market trends and leveraging opportunities to secure favorable pricing (Caniels & Gelderman, 2005). Based on Table VII, Leverage-class commodities with a total purchase value of $520,093.00 offer significant opportunities for cost savings through negotiation and bulk purchasing due to their high volume and relatively stable supply markets.
Non-Critical/routine | Leverage | Bottleneck | Strategic |
---|---|---|---|
$ 1,058,170.00 | $ 520,093.00 | $ 2,0687,298.00 | $ 1,400,984.00 |
Central Services Division must carefully follow the recommended strategy for competitive Bidding to drive down prices. From previous experience, the lowest prices vendors offer are not always the suitable choice. CSD always considers the delivery or lead time of material to be the most prominent criterion. Most leverage items depend on an importation scheme; the local content produced, such as flowmeter, switch, conveyor materials, and electrical fittings, is still low. This significantly affects the supply, which depends on the global supply chain and government regulation. Every stakeholder should consider balancing on-time delivery and the lowest cost offered.
The procurement strategy of consolidating volume to negotiate a bulk discount applies in the Central Services Division. Leverage items such as steel, electrical fittings, switches, and conveyor materials are often used in CSD construction projects. CSD can also create agreements or joint purchase agreements with other divisions, such as Operation Maintenance and Mill. Both divisions will require the same material to maintain their facility’s operation.
The long-term contracts with suppliers’ strategy, which can ensure supply price and security, have already been implemented in PT. Freeport Indonesia. Conveyor material suppliers like Sandvik already have a long history in PT. Freeport Indonesia. Sandvik has already established its vendor-managed warehouse and permanent representative on-site. This is to ensure the availability of material and technical assistance required on-site. The strategy needs to expand to other leverage items, such as flowmeters, which are also very critical parts and widely used in operations.
Strategic Items (High Profit Impact, High Supply Risk)
Strategic items such as FSS, ducting, valves, PLC panels, termination kits, circuit breakers, transformers, lube pumps, electrical switches, and electrical panels require close collaboration with suppliers due to their high impact on profits and high supply risk. With the total purchased value of $1,400,984.00 as shown in Table VII, these items are critical to the organization’s operations and necessitate a strategic approach to ensure reliability and mitigate risks. The high total purchased value highlights the importance of ensuring reliable supply chains.
Recommended Strategies: Developing strategic partnerships and alliances with key suppliers is essential. Such partnerships foster trust and cooperation, improving supply chain integration and risk management (Kraljic, 1983). Risk-sharing agreements can be implemented, where both parties share the risks and rewards, thus ensuring mutual commitment to supply continuity. Joint ventures or investments in suppliers may also be considered to secure long-term supply and strengthen relationships. Supplier development programs can be established to work closely with suppliers, improving their processes and capabilities to ensure a reliable supply of high-quality materials (Gelderman & Van Weele, 2003).
Developing strategic partnerships and alliances with key suppliers is feasible to implement and already has. CSD uses partnerships and alliances with key suppliers such as Transavia Otomasi, Siemens, ABB, and Beckers for strategic items such as PLC panels, electrical switches, and electrical panels. This becomes important to make sure all systems or infrastructures that have been constructed by the Central Services Division have proper integrations and to make sure all technical problems are efficient to manage.
Risk-sharing agreements can be implemented, where both parties share the risks and rewards. In the context of the construction industry, this strategy can be implemented with contractors and clients, who may share risks related to project delays and cost overruns. For the Central Services Division, strategic items such as Fire Suppression System (FSS) and ducting material can implement this strategy. The Central Services Division can create agreements with suppliers not only to provide material but also to provide services in installing and commissioning the material or system. There are several potential vendors that are able and have experience, such as PT Javaland for the FSS system and Daikin Indonesia or ODG for the HVAC ducting system.
Due to company policy, investments in suppliers, which may be considered to secure long-term supply and strengthen relationships, might not be feasible. CSD is a division inside PT. Freeport has no authority to invest in or create a joint venture with suppliers. This strategy might be feasible at the corporate supply chain management or global supply chain level at the parent company, FCX, which is responsible for operations in several sites, such as North and South America, including Indonesia.
Bottleneck Items (Low-Profit Impact, High Supply Risk)
Bottleneck items include remote controls, cables, pipe fittings, lighting, cable trays, compressors, and audible devices. Table VII provided information that with the largest total purchase value of $2,687,298.00, these items pose a high supply risk but have a low profit impact. The focus for these items should be on ensuring supply continuity and minimizing the risk of disruptions.
Recommended Strategies: To manage bottleneck items effectively, diversification of the supplier base is critical. Relying on multiple suppliers reduces dependency on any single supplier and mitigates the risk of supply interruptions (Seuring & Muller, 2008). Stockpiling can be employed to maintain higher inventory levels, providing a buffer against supply chain disruptions. Establishing contingency plans and agreements with suppliers ensures quick response times during shortages. Additionally, identifying and qualifying alternative sources of supply is crucial for mitigating risk and ensuring continuous supply (Kraljic, 1983).
Diversification of the supplier base is critical to resolve bottleneck supplier issues. Relying on multiple suppliers reduces dependency on any single supplier and mitigates the risk of supply interruptions. For bottleneck items such as cable, the Central Services Division still relies heavily on outside Indonesian suppliers (Okonite and Olex, which are US-based cable manufacturers) that have high supply risk regarding the availability and supply chain risk. It is recommended to diversify it with Indonesian suppliers to reduce supply risk. Companies like PT Jembo, one of the leading cable manufacturers in Indonesia, need to be considered by the procurement and bidding team. Its relative proximity to the site will be an advantage.
The Central Services Division can implement the strategy of stockpiling bottleneck commodities to maintain higher inventory levels and provide a buffer against supply chain disruptions. Bottleneck commodities that are relatively general in terms of usage in construction projects, such as lighting, cable trays, and audible devices, will benefit from material availability. The Central Services Division needs to conduct an inventory analysis to determine the optimal stock level on-site based on historical usage rates, historical lead times, and projected or future plans for construction projects.
Stockpiling strategies also need to balance. With limited storage space in the on-site consolidation center, stockpiling strategies must ensure space and resources to accommodate higher inventory. Do not proceed with this strategy if it causes logistic and storage issues.
Establishing contingency plans and agreements with suppliers ensures quick response times during shortages. Internally, the Central Services Division doesn’t have any contingency plan or agreement with suppliers; the development and documentation of a contingency plan are required. The division can look back on what happened when disruptions in the global supply chain affected project progress, such as during the COVID-19 global pandemic. Also need to be considered are negotiation agreements with suppliers that include clauses for expedited delivery and prioritized production during emergencies.
Non-Critical/Routine Items (Low-Profit Impact, Low Supply Risk)
Non-critical or routine items like gatic ditch covers, geotextiles, furniture, wall materials, paints, CCTV, doors, pipes, and cable brackets have a low-profit impact and low supply risk. Although this class poses a low-profit impact and low supply risk, the total purchased value as shown in Table VII is moderately high at $ 1,058,170.00, which is even higher than leverage class items. The strategy for these items should focus on efficiency and cost- effectiveness.
Recommended Strategies: Standardizing specifications can significantly reduce complexity and procurement costs for non-critical items. Automated ordering systems can streamline procurement processes, reducing administrative overhead and enhancing efficiency (Lambert & Cooper, 2000). Utilizing preferred suppliers can benefit from economies of scale and ensure consistent quality. Adopting just-in-time inventory practices helps minimize holding costs and avoid overstocking, ensuring that inventory levels are kept optimal (Gunasekaran & Ngai, 2005).
The strategy of standardizing specifications can significantly reduce complexity and procurement costs for non-critical items. The engineering team of the Central Services Division needs to emphasize standardization or limit design variability without sacrificing the safety factors or operability expectations. With this strategy, any surplus (leftover) and stand-by material will be easier to reallocate to more priority works or projects. On the other side, with standard specifications, engineering will maintain lower supply risk due to more common products and vendors in the market. The most feasible commodities for implementing this strategy are wall/building materials, paints, and pipes.
Utilizing a preferred supplier strategy can benefit economies of scale and ensure consistent quality. Historical data on purchase orders for every commodity in construction material procurement will be valuable for this strategy. The current process in the Central Services Division has already implemented this strategy but is not yet consistent due to many suppliers not always being available to provide the quotation or product. Close or more intense communication in supplier relationships needs to be emphasized, or a database of preferred suppliers should be created or categorized.
Implementing automated ordering systems can streamline procurement processes, reduce administrative overhead, and enhance efficiency. It is crucial to align this strategy with the preferred suppliers’ approach to leverage the benefits of automated ordering systems effectively in non-critical/routine commodities. The speed of procurement and just-in-time delivery became the main key performance indicators. Central Services Division has a limited on-site consolidation center of construction materials, and this strategy will reduce the probability and occurrence of long-term storage that can risk material missing and damaged.
Commodities can now be categorized into four quadrants, each with more specific strategies within these quadrants. It is possible to move between these quadrants, which can be triggered by either market changes or company decisions (Rahman & Nofrisel, 2018). In general and in simple ways, the Central Services Division can do two things—find new suppliers to move the product to a better area or take advantage of economies of scale if possible. On the other hand, changes in the market can happen when the number of suppliers increases, new technology is introduced, or regulations change. Another thing that can be considered is that the Central Services Division needs to reach out to its suppliers to reduce supply risk to justify the profit impact of commodities.
Conclusion
By categorizing procurement items based on the Kraljic Portfolio Matrix, PT Freeport Indonesia ultimately Central Services Division can develop tailored strategies that address the unique characteristics of each category. Leveraging competitive bidding and volume consolidation for leverage items, fostering strategic partnerships with suppliers for strategic items, diversifying suppliers, maintaining higher inventories for bottleneck items, and streamlining procurement processes for non-critical items will enhance procurement efficiency, reduce costs, and mitigate risks. Integrating these strategies ensures that procurement practices align with the overall goals of increasing construction material availability at the site, reducing excessive inventory, cost reduction, and operational efficiency, ultimately contributing to the organization’s success.
Appendix
Commodity | Total quantity purchased | Tota purchased value | Lead time | Cost per unit |
---|---|---|---|---|
Actuator | 2 | $ 16,563.00 | 208.5 | $ 8281.26 |
Audible device | 3 | $ 11,499.00 | 255.5 | $ 3832.92 |
Cable brackets | 26643 | $ 327,543.00 | 175.96 | $ 61.12 |
Cable Trays | 9 | $ 5,980.00 | 363 | $ 664.51 |
Cables | 64931 | $ 1,182,568.00 | 128.06 | $ 25.64 |
CCTV | 1 | $ 2,036.00 | 106 | $ 2035.68 |
Circuit breakers | 10 | $ 20,715.00 | 254.75 | $ 2538.5 |
Compressor | 1 | $ 44,482.00 | 119 | $ 44481.85 |
Conveyor | 121 | $ 118,111.00 | 159.33 | $ 1152.99 |
Doors | 20 | $ 49,089.00 | 132.36 | $ 2743.3 |
Ducting | 3301 | $ 438,462.00 | 228.06 | $ 3301.58 |
Electrical fittings | 1495 | $ 12,659.00 | 210 | $ 214.65 |
Electrical panels | 80 | $ 399,446.00 | 290.39 | $ 7245.27 |
Electrical switch | 8 | $ 20,693.00 | 291.5 | $ 2303.9 |
Flowmeter | 8 | $ 27,626.00 | 111.5 | $ 1942.21 |
FSS | 625 | $ 127,705.00 | 222.38 | $ 6406.68 |
Furniture | 229.7 | $ 33,540.00 | 99.86 | $ 1742.02 |
Gatic ditch | 10 | $ 3,106.00 | 67 | $ 487.43 |
Geotextile | 10070 | $ 63,165.00 | 139.67 | $ 6.39 |
Interface panel | 652.5 | $ 135,492.00 | 153.66 | $ 8565.27 |
Lighting | 749 | $ 662,282.00 | 291.38 | $ 1315.36 |
Lube pump | 13 | $ 63,451.00 | 152.25 | $ 4073.78 |
Paints | 6072 | $ 253,774.00 | 79.71 | $ 228.24 |
Pipe fittings | 1499 | $ 742,077.00 | 173.11 | $ 931.95 |
Pipes | 466 | $ 312,879.00 | 150 | $ 2466.63 |
PLC panel | 4 | $ 37,271.00 | 253.75 | $ 7072.83 |
Remote | 1 | $ 10,660.00 | 261 | $ 10660 |
Steel | 504 | $ 156,519.00 | 112.33 | $ 3711.57 |
Switch | 25 | $ 69,686.00 | 197.94 | $ 6278.25 |
Terminations kits | 15 | $ 14,817.00 | 230.38 | $ 1463.33 |
Transformer | 35 | $ 85,838.00 | 203 | $ 6781.28 |
UPS | 6 | $ 11,187.00 | 269.67 | $ 3636.48 |
Valves | 54 | $ 192,586.00 | 223 | $ 6014.98 |
Wall material | 100 | $ 13,038.00 | 138 | $ 177.43 |
References
-
Bardy, R., & Hillebrand, A. (2011). Procurement strategies in multi- layered supply chains. In S. Renko (Ed.), Supply chain management (pp. 93–140). Rijeka: IntechOpen.
DOI |
Google Scholar
1
-
Caniels, M. C., & Gelderman, C. J. (2005). Purchasing strategies in the Kraljic matrix—A power and dependence perspective. Journal of Purchasing & Supply Management, 11(2–3), 141–155.
DOI |
Google Scholar
2
-
Carlson, C. S. (2012). Understanding the fundamental definitions and concepts of FMEAs. In C. S. Carlson (Ed.), Effective FMEAs: Achieving safe, reliable, and economical products and processes using failure mode and effects analysis (pp. 21–55). Willey. https://doi.org/10.1002/9781118312575.ch3.
DOI |
Google Scholar
3
-
Chanamool, N., & Thanakorn, N. (2016). Fuzzy FMEA application to improve decision-making process in an emergency department. Applied Soft Computing Journal, 43, 441–453.
DOI |
Google Scholar
4
-
Chang, D. -C., & Sun, K. (2009). Applying DEA to enhance assessment capability of FMEA. International journal of quality and reliability management, 26(6), 629–643.
DOI |
Google Scholar
5
-
Charnes, A., Cooper, W. W., & Rhodes, E. (1978). Measuring the efficiency of decision making units. European Journal of Operational Research, 2(6), 429–444.
DOI |
Google Scholar
6
-
Chin, K. -S., Wang, Y. -M., Poon, G. K., & Yang, J. -B. (2009). Failure mode and effects analysis by data envelopment analysis. In: Decision support systems (vol. 48, no. 1, pp. 246–256). Netherlands: Elsevier B.V. https://doi.org/10.1016/j.dss.2009.08.005.
DOI |
Google Scholar
7
-
Dagsuyu, C., Gocmen, E., Narli, M., & Kokangul, A. (2016). Classical and fuzzy FMEA risk analysis in a sterilization unit. Computers & Industrial Engineering, 101, 286–294.
DOI |
Google Scholar
8
-
Despotis, D. K., Stamati, L. V., & Smirlis, Y. G. (2010). Data Envelopment Analysis with nonlinear virtual inputs and outputs. European Journal of Operational Research, 202(2), 604–613.
DOI |
Google Scholar
9
-
Dinmohammadi, F., & Shafiee, M. (2013). A Fuzzy-FMEA risk assessment approach for offshore wind turbines. International Journal of Prognostics and Health Management, 4(3), 1–10.
DOI |
Google Scholar
10
-
Gadde, L. E., Hakansson, H., & Persson, G. (2010). Supply Network Strategies. John Wiley & Sons.
Google Scholar
11
-
Gelderman, C. J., & Van Weele, A. J. (2003). Handling measurement issues and strategic directions in Kraljic’s purchasing portfolio model. Journal of Purchasing and Supply Management, 9(5–6), 207–216. https://doi.org/10.1016/j.pursup.2003.07.001.
DOI |
Google Scholar
12
-
Gunasekaran, A., & Ngai, E. T. (2005). Build-to-order supply chain management: A literature review and framework for development. Journal of Operations Management, 23(5), 423–451. https://doi.org/10.1016/j.jom.2005.04.002.
DOI |
Google Scholar
13
-
Kraljic, P. (1983). Purchasing must become supply management. Harvard Business Review, 61(5), 109–117.
Google Scholar
14
-
Lambert, D. M., & Cooper, M. C. (2000). Issues in supply chain management. Industrial Marketing Management, 29(1), 65–83. https://doi.org/10.1016/S0019-8501(99)00113-3.
DOI |
Google Scholar
15
-
Monczka, R. M., Handfield, R. B., Giunipero, L. C., & Patterson, J. L. (2015). Purchasing & Supply Chain Management. Boston: Cengage Learning Emea.
Google Scholar
16
-
PT. Freeport Indonesia. (2023, December 2). Our Project Area. Retrieved from PT. Freeport Indonesia. https://ptfi.co.id/id/our-operation-areas.
Google Scholar
17
-
Rahman, A. N., & Nofrisel (2018). Analysis of material project purchasing strategy using Kraljic’s Method. Advances in Economic, Business and Management Research, 72, 225–230. https://doi.org/10.2991/icbmr-18.2019.37.
DOI |
Google Scholar
18
-
Seuring, S., & Muller, M. (2008). From a literature review to a conceptual framework for sustainable supply chain management. Journal of Cleaner Production, 16(15), 1699–1710. https://doi.org/10.1016/j.jclepro.2008.04.020.
DOI |
Google Scholar
19
-
Stamatis, D. H. (2003). Failure Mode and Effect Analysis: FMEA From Theory to Execution. Milwaukee: American Society for Quality, Quality Press.
Google Scholar
20
-
Yousefi, S., Alizadeh, A., Hayati, J., & Baghery, M. (2018). HSE risk prioritization using robust DEA-FMEA approach with undesirable outputs: A study of automotive parts industry in Iran. Safety Science, 102, 144–158.
DOI |
Google Scholar
21
